Skip to content

Project Tracking and Control

  • simple methods to track
    • Periodic meetings where team members report progress.
    • Evaluating the results of reviews and audits conducted as part of the software engineering process.
    • Tracking formal project milestones.
    • Comparing actual start dates with scheduled start dates.
    • Meeting engineers and having informal discussions.
    • Using a formal method like earned value analysis.

Earned Value Analysis EVA

  • EVA can be used to:
    • report current/past project performance
    • predict future project performance based on current/past performance

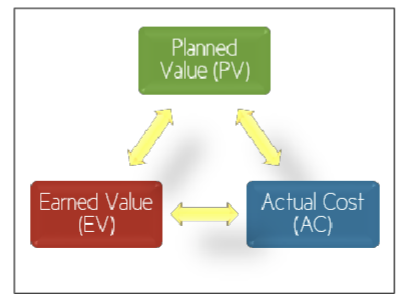

  • Results can be expressed in dollars and/or percentage alt text

EVA calculation

  • Planned Value (PV)
    • The authorized budget assigned to scheduled work. It represents the portion of the approved cost estimate planned to be spent on a given activity during a specific time period.
  • The Earned Value (EV)
    • The value of the work actually completed, expressed in terms of the approved budget for that work.
  • Actual Cost (AC)
    • The total cost incurred for the work completed on a specific activity during a given time period.
  • Schedule Variance Analysis
    • Uses EV and PV to calculate a variance to the project schedule.
  • Schedule Variance
    • SV=EVPV
    • Expressed in currency units (e.g., dollars). A positive value indicates ahead of schedule; negative means behind.
  • Schedule Performance Index
    • SPI=EV/PV
    • A ratio (i.e., a fraction). An SPI>1 indicates better than planned schedule performance; SPI<1 means worse

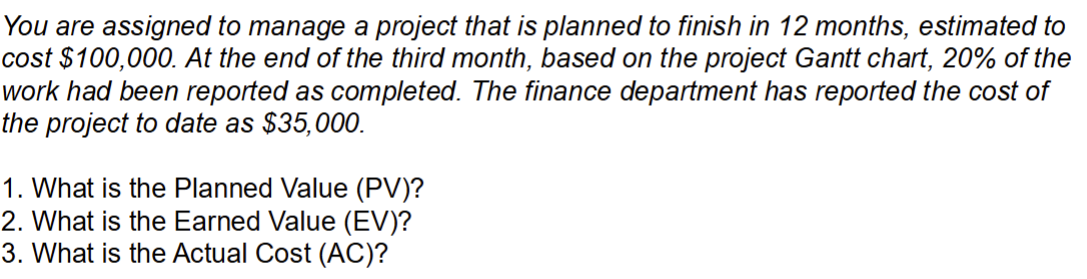

EVA metrics example !!

alt text
